For phased lighting orders, release only the fixture quantities tied to a phase whose location, current fixture and quantity documents, installation timing, and receiving plan are all confirmed. The project total tells you how much the whole job needs. It does not tell you which areas are ready to take delivery.

Keep every other quantity unreleased until its own conditions check out. This is a practical project-control method, not an industry mandate. It keeps early shipments from locking later phases into assumptions nobody has confirmed yet.

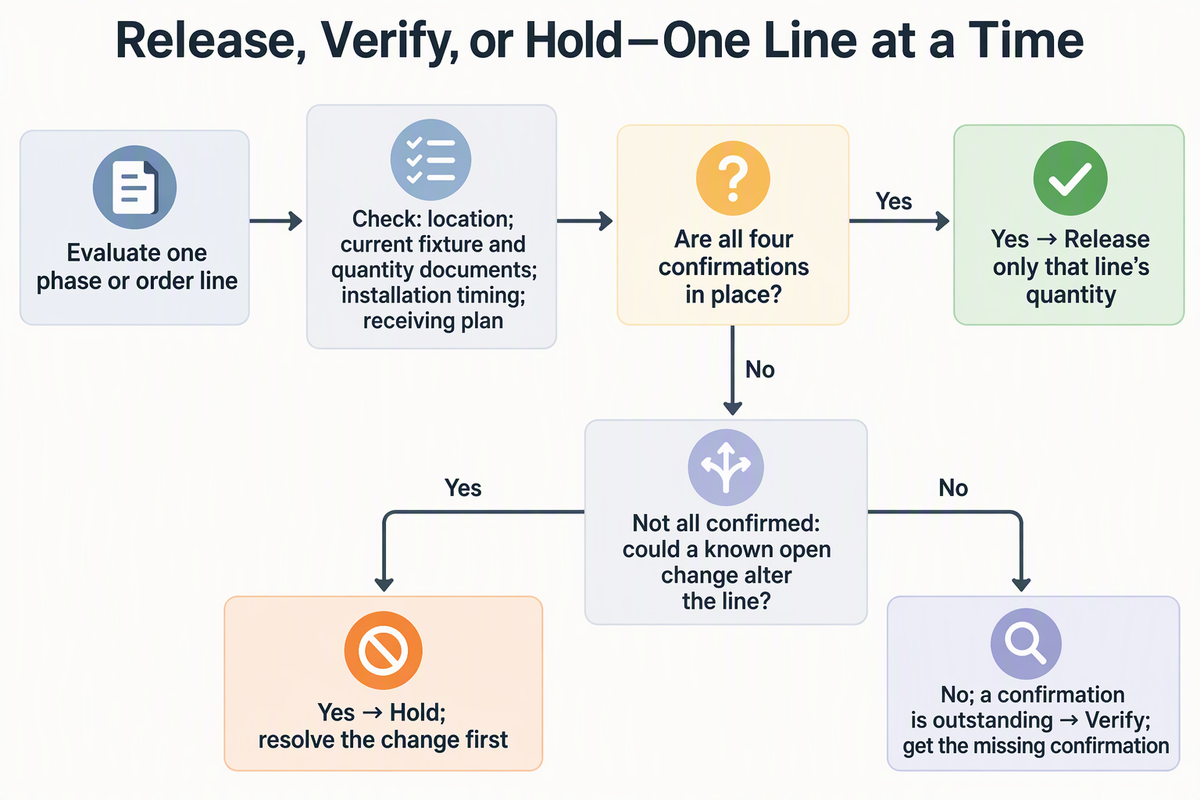

Release a phase only when its own fixture lines are ready
Make the release decision for each phase or order line, not once for the combined total. Each line needs four separate confirmations before its quantity moves.
Treat these as distinct checks, because one can pass while another fails:
- Location: the building, floor, or area the line serves is defined and open for this phase.
- Current documents: the fixture schedule revision and the quantity for that area match what you plan to release.
- Installation timing: the crew and sequence for that area are scheduled, so fixtures will not sit waiting for work that has not started.
- Receiving plan: someone has confirmed who accepts the delivery, where it goes, when it can arrive, and where it will be stored.
Documents often gate the rest. Procore's general construction guidance calls for submittal approval before ordering, so a required submittal that is still under review can keep its associated line from release. Contract terms can also set dates. On federal design-build work, the agency's scope of work under FAR 36.302 scope rules may include schedule or delivery requirements, so read that document before you set a release date. On private jobs, the contract documents and the project's jurisdiction set those terms instead.
| Status | Condition | Next action |
|---|---|---|
| Release | All four confirmations in place | Release only that line's quantity |
| Verify | A confirmation is still outstanding, no known conflict | Keep unreleased; get the missing confirmation |
| Hold | A known open change could alter the line | Keep unreleased; resolve the change first |
Verify and hold both leave the quantity unreleased, but they call for different work. A verify line is waiting on an answer, such as a delivery window the site superintendent has not sent yet. A hold line has a live problem, such as a layout revision that could change the fixture type or count. Chasing a confirmation will not clear a hold. Only resolving the change will.
Some open items are not yours to settle. If a line depends on an unresolved technical or code question, route it to the licensed electrician, lighting designer, engineer, or authority having jurisdiction for the project. This article does not replace their judgment, wiring decisions, or code-compliance review.
If a line's configuration was never pinned down during pricing, run a commercial lighting quote scope check before giving it a status. When we are shipping the release, compare our shipping policy with the receiving window the site has confirmed.
Separate ready quantities from unresolved later phases
Keep each phase's quantity as its own line in the project record, so one confirmed phase can be released while later phases stay visibly unreleased. If the only number on file is the project total, it becomes easy to release everything at once or lose track of what already shipped.
A simple release register makes the split visible. Useful fields include phase or area, fixture or order-line identifier, planned quantity, released-to-date quantity, remaining quantity, document revision, installation timing, and receiving confirmation. The released-to-date and remaining columns matter most. They show at a glance how much of a fixture type is committed and how much still depends on future confirmations.
Here is an illustrative split using labels only. Building A, Phase 1 shows its planned quantity fully released, with revision, install date, and receiving contact filled in. Building B, Phase 2 uses the same fixture type but shows zero released, because its receiving contact is blank. Building C, Phase 3 shows zero released and a note that its layout is under revision. Each row carries its own status, even when the fixture type repeats.

That last point is where phased lighting orders tend to drift. A later area that uses the same approved fixture schedule as an earlier one is not ready for that reason alone. Its own location, timing, and receiving conditions still decide its status. If later-phase layouts are still moving, classify open layout items before those quantities go anywhere near release.
A register tracks readiness. It does not decide whether a contract or purchase order can be split, staged, or amended. Those terms come from the contract documents and the purchase agreement. So confirm them separately before you plan to release lighting orders on a phased commercial project in stages.
You do not have to build the register from scratch. PLOT, which also markets paid procurement software, offers a free procurement log spreadsheet template with fields for required-on-site dates, schedule activities, submittal status, and order deadlines. Add your own phase, released-to-date, and receiving columns, then adjust it to your project's actual requirements.
Recheck only the lines affected by a change
When a site condition, schedule entry, or project document changes, trace it to the lines it touches and reassess only those. Reopening the whole project total wastes time. Skipping the trace can leave an affected line marked "release" on outdated inputs.
- Record the change. Note what changed (a site condition, a schedule date, or a document revision), the new revision or version number, and the date you learned of it.
- Map it to phases and lines. Identify every phase and order line that depends on the changed input. A revised Building B layout may touch several fixture lines in Phase 2 and none in Phase 1.
- Compare each affected line against current information. Check fixture identity and quantity, location, installation timing, and the delivery and receiving plan against the updated inputs.
- Assign an updated status. Move the line to release, verify, or hold. For anything short of release, write down the specific confirmation or resolution still needed.
- Confirm the untouched lines. Leave a line's status as recorded only if none of its supporting inputs changed. A schedule slip can shift installation timing for lines whose documents never moved.
Mounting changes deserve extra care, since a substituted mount can affect support, access, and trade coordination at the same time. Review mounting substitutions before an affected line returns to release. If the change raises a technical or code question, the line stays on hold until the responsible project professional or authority answers it.
Your next step is to put phased lighting orders into that register now. Give each phase line a status, and next to every verify or hold line, record the one confirmation or change that would move it forward.
FAQs
Does an approved fixture schedule for the whole project make every phase ready?
No. An approved schedule confirms what fixtures the project uses. It does not confirm that a specific phase's area is open, its crew is scheduled, or its delivery can be received. Each phase still needs its own location, timing, and receiving confirmations before its quantity is released.
What should happen when an area is ready to install but receiving is not confirmed?
Keep that quantity unreleased with a verify status. A shipment without a confirmed receiver, drop location, delivery window, and storage spot may not be usable where or when the crew needs it. Once the site names who accepts delivery and where it goes, the line can move to release.
Should a change in one phase reopen phases that were already released?
Only if the change touches an input those phases depend on. A layout revision limited to Phase 3 does not by itself affect Phase 1. A shared change, such as a revised fixture schedule revision or a new site-wide delivery route, can reach released lines too. Trace the change before assuming either way.
Who decides whether a changed line still meets code or technical requirements?
That call belongs to the project's licensed electrician, lighting designer, engineer, or authority having jurisdiction, working from the contract documents. The release register should flag the question and keep the line on hold. It should not answer the question itself.
