How to Verify a Lighting Schedule Against the Actual Room Names

A step-by-step crosswalk method for tracing every scheduled fixture group to one room and task, separating label drift from scope changes before ordering.

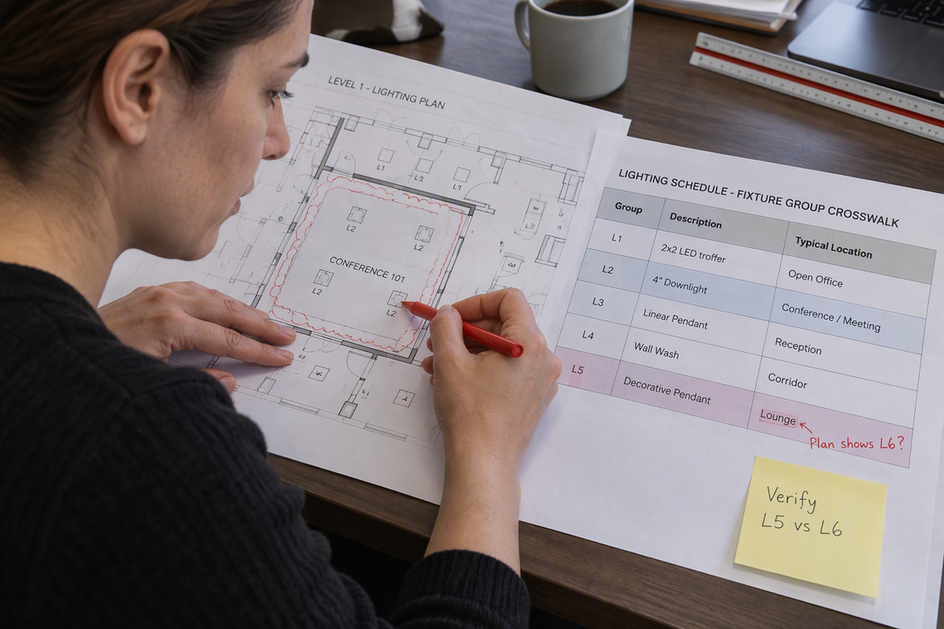

A project coordinator compares a commercial lighting schedule, a room plan, and a crosswalk worksheet, with one unresolved row left open.
Share
In this article
  1. Start With a Room-to-Fixture Crosswalk
  2. Set the Current Document and Revision Baseline
  3. Match Each Room Name to a Physical Location
  4. Check the Fixture Group Against the Room's Task
  5. Resolve Open Rows Before Order or Installation
  6. FAQs
  7. What if the same room name appears in more than one location?
  8. How should I record a room that was renamed?
  9. Can one fixture tag cover more than one room?
  10. How do I check a commercial lighting schedule against the rooms when the quote uses its own labels?

Lighting schedule verification comes down to one tool: a room-by-room crosswalk built from the current project documents. Give each scheduled fixture group its own row. Trace that row to one identifiable location and the task documented for that space, then mark it confirmed or open.

Some rows involve a room that was renamed, repeated, split, combined, or reassigned. Those rows stay open until the responsible project contact confirms the mapping. That way a labeling problem doesn't turn into a wrong order or a misplaced install.

Start With a Room-to-Fixture Crosswalk

A crosswalk is a simple working table. It lines up what the schedule says with where each fixture group goes and why. It's a practical method, not a required industry form, so build it in whatever spreadsheet your team already uses.

  1. Create one row per scheduled room and fixture-group assignment. If one room carries two fixture tags, it gets two rows.
  2. Copy the room name or number and the fixture tag exactly as the schedule shows them, including abbreviations and typos.
  3. Record the sheet or document number and revision for every source you check against that row.
  4. Match the row to an identifiable location on the current plan, not just a room with a similar name.
  5. Check the documented task and fixture-group assignment for that location.
  6. Mark the row confirmed or open, and add a short note on why.

A project coordinator compares a commercial lighting schedule, a room plan, and a crosswalk worksheet, with one unresolved row left open.

A finished row might read: schedule label, fixture tag, plan location, document references, task check, status. Treat an open row as a question, not a mapping. Don't copy it into an order, a pick list, or an installation plan as if it were settled.

Set the Current Document and Revision Baseline

Your check only works when everyone compares the same versions. Before you match a single label, list each source and its current revision.

  • Lighting schedule: document ID plus the revision or issue mark shown on it.
  • Plan sheets: the sheet numbers and revisions that show the rooms in scope.
  • Quote: quote number and revision, so line items tie back to the right schedule.
  • Installation plan: its identifier and revision, if it is a separate document.
  • Shared room-data reference: only if the project documents name one.

Confirm with your project contact which versions are current before you start comparing labels. Some projects name a single source for room information. FIU's project-specific room-data reference is one example. Its BIM specification has room information assigned in the Architectural model, and every other project model that uses room information must reference it.

That rule belongs to FIU's projects, not to every job. If your documents don't name a shared reference, a document's format or date won't tell you which one controls room names. Ask the project contact instead. If the quote revision lags behind the drawings, our quote scope check covers the rest of that review.

Match Each Room Name to a Physical Location

A schedule label counts as matched when it points to exactly one location you can find on the current plan. Use the room name or number together with whatever other location cues the plans actually show.

  • Pair the label with other identifiers. Floor, wing, building area, grid lines, or another clear location reference all help. Not every plan carries all of these, so use what your current documents show.
  • Keep both labels for a confirmed rename. When the project confirms an old and a new name refer to the same space, record both in the row so the next reviewer can trace the change.
  • Separate repeated labels. If "Storage" appears on two floors, give each its own row. Keep both open until other identifiers tell them apart.
  • Flag split or combined rooms. One old room may now be two, or two may now be one. Keep the affected rows separate and open, because a boundary change can change scope.

If your schedule started from field notes, our site-walk schedule guide shows how to build traceable location rows from the start. Labeled photos and zone measurements in a lighting project brief give installers another way to recognize a space. The agreed mapping still comes from the project documents.

Check the Fixture Group Against the Room's Task

No. A matching room name only proves the label lines up. The fixture group and the room's documented task each need a separate check.

  • Compare assignments across documents. Put the fixture tag or group from the schedule next to what the quote and installation plan assign to the same row.
  • Check the documented task or use. Here's an illustrative case: the schedule still calls a room storage, but the current plan labels it a break room. That's a use change, not a typo.
  • Label-only mismatch. Same location, same task, same fixture group, different name. Record the alias, and the row can move toward confirmed.
  • Changed boundary, use, or group assignment. Treat this as a scope question. Don't edit the room label just to make the documents look consistent.

This check covers one thing: whether the documents agree on room, task, and fixture group. It doesn't judge fixture choice, light levels, circuits, or code compliance. Those belong to the designer, engineer, or electrician of record. Questions about layout or light levels can go to a separate lighting design review.

Resolve Open Rows Before Order or Installation

Only rows with a confirmed location and a matching documented assignment move forward. Every other row stays open until the responsible project contact confirms it and you record the agreed mapping.

Row condition Disposition Next action
Location and assignment align Confirmed Carry into order or install plan
Duplicate, unclear, or conflicting label Open Request mapping confirmation
Changed boundary, use, or group Open: scope question Clarify before ordering
Confirmation received Confirmed Log who, when, and which documents

Decision diagram showing when a lighting schedule crosswalk row is confirmed, remains open, or needs a scope clarification.

Don't pick a winning document on your own. United-BIM's construction guidance shows how conflicting project documents get clarified. When a door schedule disagrees with the floor plan, an RFI asks the design team to confirm the requirement instead of letting the contractor choose. That example is a door schedule, but the same logic fits a lighting row. The communication route depends on the project's contract and agreed procedures.

Timing also changes the route. CSI guidance on clarification routes explains that requests during bidding or procurement fall under the project's instructions to bidders. Requests during construction fall under the contract documents. Check which one applies to your project before you treat a reassigned room as settled. When the answer comes back, note it on the row with the document references. That's the last step of lighting schedule verification: every row is either confirmed and traceable, or still visibly open.

FAQs

What if the same room name appears in more than one location?

A repeated name is not a unique match, so it can't confirm a row by itself. Give each space its own row. Then separate them using identifiers the current documents actually show, such as floor, wing, or room number. If the rows still can't be told apart, keep both open and ask the project contact which location each fixture group belongs to.

How should I record a room that was renamed?

Keep the old and new labels side by side in the same row, but only after a project record confirms they refer to the same physical room. Note which document or response confirmed it, with its revision. Anyone checking the order or installation plan later can then trace why the schedule label differs from the current plan.

Can one fixture tag cover more than one room?

It can when the project documents assign it that way, but the tag alone doesn't tell you which rooms it covers. Give each physical location its own crosswalk row, even when they share a tag. Confirm each row against the schedule, quote, and installation plan, and keep any location the documents don't clearly assign open.

How do I check a commercial lighting schedule against the rooms when the quote uses its own labels?

Treat the quote's labels as one more alias in the crosswalk. Add a column for the quote's room or line-item label next to the schedule label. Then tie each quote line to the same physical location and fixture tag. If a quote line can't be traced to one row, flag it open before the quote is approved.

More to Read

How to Set Lighting Priorities for a Multi-Use Commercial Room Oct 20, 2026 How to Set Lighting Priorities for a Multi-Use Commercial RoomA practical planning method for shared commercial rooms: build a task map, match it to one layout, zones, or a task layer,... How to Plan Lighting for a Work Area Beside Tall Utility Cabinets Oct 20, 2026 How to Plan Lighting for a Work Area Beside Tall Utility CabinetsA practical method for cabinet-side work zones: record a task-area baseline, read the shadow pattern, and gather layout and fixture inputs before... How to Tell Whether a Lighting Retrofit Has Solved the Original Complaint Oct 20, 2026 How to Tell Whether a Lighting Retrofit Has Solved the Original ComplaintUse a like-for-like before-and-after check to see whether a retrofit fixed the reported problem, and sort results as resolved, partial, or inconclusive.
